Industry news

Amortising Tooling: When a Fixture Pays for Itself

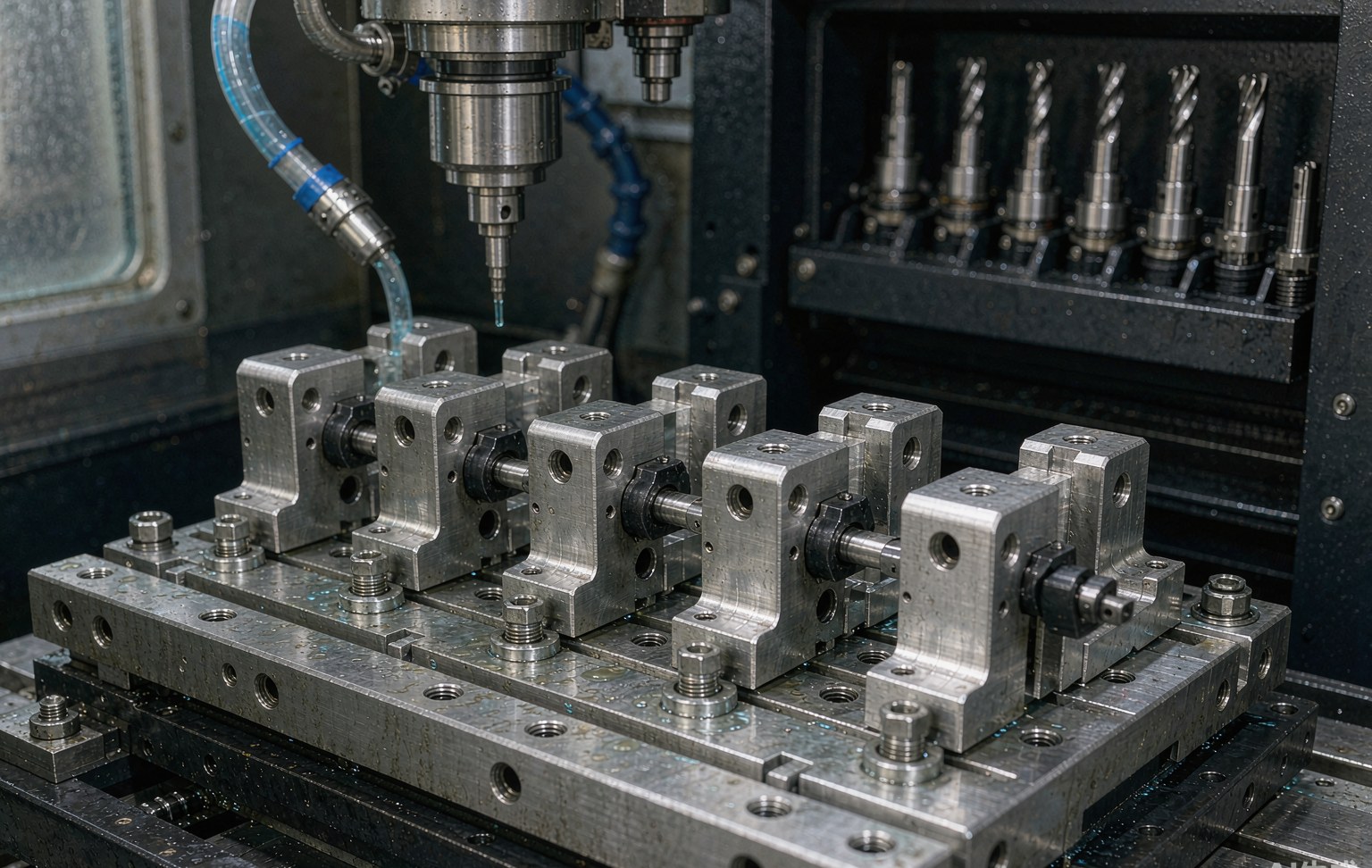

A multi-part aluminium milling fixture bolted to a CNC machining centre table, holding six identical machined brackets with toe clamps and locating pins

A buyer asks for 250 pieces of an aluminium housing and gets two quotes. Supplier A prices the part at $11.40 with a one-off "tooling: $850" line. Supplier B prices the same part at $12.60 with no tooling line at all. The naive comparison says B wins on the first order and A wins from piece 700 onward. The real answer is that the two quotes describe two different contracts — one where you own a fixture, and one where you never will — and the correct choice depends on questions that have nothing to do with the unit price.

That decision is what this article is about. We covered setup cost generally in a separate piece (why one part costs 10x more than a hundred); here we go one level deeper, into the fixture itself: what tooling actually is, the three ways suppliers charge for it, the arithmetic of fixture cost amortisation, and — the part buyers get wrong most often — who owns the fixture after it is built. These are the numbers we run internally at Ningbo Renjiu Machinery every time a quote needs dedicated workholding, and the decision rule at the end is the one we would use if we were buying the part instead of making it.

What "Tooling" Actually Covers on a Machined Part

When a quotation says "tooling not included", the word covers a wider family of objects than most buyers assume. Some of them are true one-offs; others are consumables that get quietly rebuilt every order. Knowing which is which changes what you should be willing to pay for.

Tooling itemTypical cost rangeReused on reorder?Worth owning?
Machined soft jaws (lathe or mill)$40–120 per setOften re-cut each orderRarely — it is closer to consumable setup material than an asset
Dedicated milling fixture, 3-axis part$400–1,200Yes, for yearsYes above roughly 300–500 lifetime pieces
Hydraulic or pneumatic fixture$1,500–5,000YesOnly with a committed production programme
Vacuum fixture (thin-wall, plate parts)$600–2,000YesYes when distortion or marking is the constraint
Multi-part pallet / tombstone layout$800–3,000YesYes — usually the fastest payback of all
Form tools, custom drills, thread mills$80–600 per toolConsumed, re-boughtNo — these are the supplier's cost of doing business
Checking fixture or go/no-go gauge$300–1,500YesYes on safety-critical or high-volume features

Two lines in that table deserve emphasis. Soft jaws are the most commonly "charged" item and the least legitimately one: a serious shop treats re-cutting soft jaws as part of setup, the same way it treats rubbing down parallels. If a quote carries a $60 soft-jaw line, that is a shop telling you how it splits hairs, not a real asset transfer. Form tools, likewise, are consumed by cutting parts — a supplier who bills you for a worn-out form tool on reorder is billing you for their own production consumables.

The items worth arguing about are the true fixtures: the purpose-built plates, clamps, locators and pallets that exist only for your part number. Those are genuine assets with genuine resale and transfer value, and everything below is about them.

The Three Ways Suppliers Charge for Fixtures

Every quotation with dedicated workholding in it resolves to one of three commercial structures. They are not interchangeable, and the difference matters more as quantity grows.

StructureHow it appears on the quoteWho owns the fixtureWhere it bites
One-off tooling chargeSeparate line: "tooling / fixture: $X", billed with the first POYou — if the PO says soFirst order looks expensive; competitive quotes get harder to compare
Amortised into piece priceNo tooling line; unit price is higher, or stepped down by quantityUsually the supplier, unless stated otherwiseReorders keep paying for a fixture that was paid off long ago
Supplier-owned "free tooling"No line; supplier absorbs it as a customer-acquisition costSupplier, unambiguouslyLeaving is expensive: a new supplier must rebuild it, or you pay for what you thought was free

None of the three is a scam. Supplier-owned tooling is a legitimate pricing strategy — the supplier is betting on your repeat business and pricing the fixture as marketing. Amortisation is legitimate too, provided the schedule is written down. The failure mode is silence: a quote that does not say which structure it uses, so the buyer cannot see that the $1.20/pc premium on reorder is the $850 fixture being charged a fourth, fifth and sixth time.

This is the same audit discipline we described in reading a quotation line by line — lines that are missing are where the money hides. Tooling is simply the line that goes missing most often, because "no tooling charge" reads as good news on the first order.

The Amortisation Math: A Worked Example

Fixture cost amortisation is one division and one comparison. The supplier spends F on a fixture. The fixture saves s per part — through shorter load time, a thinner wall of stock, less scrap, or the ability to run six parts per cycle instead of one. The fixture pays for itself at N = F / s parts. Everything after part N is pure saving; everything before it is a subsidy you are paying one way or another.

Here is a real-shaped example, with numbers we would actually defend in a quote. A 6061-T6 sensor bracket, 130 × 90 × 12 mm, currently quoted at $9.80/pc in a standard vise, two setups, one part per cycle. A dedicated fixture at $850 lets us hold it on three sides, merge the two setups into one, and run four parts per cycle. The new quote is $7.40/pc.

Order quantityBuy without fixture: $9.80/pcBuy with $850 fixture: $7.40/pc + fixtureTotal at each priceWinner
100$980.00$740 + $850 = $1,590.00$610 gapNo fixture, by $6.10/pc
250$2,450.00$1,850 + $850 = $2,700.00$250 gapNo fixture, by $1.00/pc
355$3,479.00$2,627 + $850 = $3,477.00break-evenFixture pays for itself here
500$4,900.00$3,700 + $850 = $4,550.00$350 savedFixture, $3.50/pc better
1,000$9,800.00$7,400 + $850 = $8,250.00$1,550 savedFixture, $6.10/pc better
2,500$24,500.00$18,500 + $850 = $19,350.00$5,150 savedFixture, $5,150 better on one programme

Three observations fall out of that table, and they generalise:

  • Break-even quantity is almost never round and almost never where intuition puts it. $850 ÷ $2.40 saving = 354.2 pieces. Buyers who guess "the fixture pays off after the first order" are wrong by an order of magnitude on parts with small per-piece savings; buyers who refuse fixtures under 500 pieces are wrong on parts with big per-piece savings. Only the division tells you.
  • The saving per part is doing more work than the fixture price. Halve the fixture to $425 and break-even moves to 177 pieces. Halve the saving to $1.20 and break-even explodes to 708 pieces. When a supplier proposes a fixture, ask for the two numbers separately — fixture cost and expected per-piece saving — and check the second against your own view of the cycle time.
  • Amortisation is just the same division spread over the order book. A supplier who "amortises" the $850 over the first 500 pieces is charging you $1.70/pc extra for pieces 1–500 and nothing after. If your programme will run 2,500 pieces, amortisation costs you $4,250 and the one-off costs you $850. The one-off is almost always cheaper if you are confident in the volume — which is precisely why suppliers prefer to amortise, and why the schedule matters.

Run your own numbers before accepting any tooling line; our free CNC machining cost calculator breaks the piece price into material, machining and setup so you can see what the fixture is actually buying.

Where the Per-Piece Saving Actually Comes From

Because the break-even hinges entirely on s, it is worth knowing the four honest sources of fixture savings — and the one dishonest one.

Load time. A part that takes 90 seconds to indicate, clamp and touch off in a vise takes perhaps 15 seconds to drop into a dedicated fixture with fixed locators. Across a 6-minute cycle that is a direct 20% capacity gain on the machine, which prices into the hourly rate calculation we described in what $40, $60 and $90 per hour actually buy.

Setup elimination. A two-setup part becomes a one-setup part when the fixture reaches the features a second op would have cut. You save the second setup and the tolerance stack between the two datums — which is sometimes the real reason to build the fixture, when the print has a true position called between features cut in different ops.

Multi-part cycles. Four parts per cycle divide the fixed elements of the cycle — tool approach, retract, tool changes — by four. On small brackets this is routinely the largest single saving and the reason a multi-part pallet pays back faster than any other tooling on the list above.

Scrap and rework. Repeatable location means the same datum every time: less variation in a critical dimension, fewer first-off rejections, less re-clamping damage on cosmetic surfaces. This saving is real but the hardest to promise in advance; treat supplier claims about it with friendly scepticism until the first-article report proves them.

The dishonest version is a fixture "saving" that is really just a quoting artefact — a supplier padding the non-fixture quote to make the fixture quote look generous. The defence is to ask for cycle time and load time on both routings, which a serious shop will state on the quote, as covered in our piece on why two suppliers quote the same part three times apart.

Who Owns the Fixture — and the Second-Supplier Problem

Here is the clause that matters more than any number in this article: if you paid for it, you own it, and it is transferable.

The scenario plays out the same way every time. You accept an $850 tooling charge on order one. Eighteen months later you need a second source — capacity, price, or simply risk. You discover that the quote you signed said nothing about ownership, the fixture lives in the supplier's tool crib with their asset tag on it, and your options are to pay them again to release it, pay a new shop to rebuild it from your drawing, or stay. None of those is a negotiation position; all three are a tax on the missing sentence in the PO.

The same logic, run in reverse, explains supplier-owned tooling. A shop that absorbs the fixture is not being generous — it is buying a switching cost, and on a part with $2,000 of dedicated workholding that switching cost is entirely rational. You do not need to refuse it. You need to know it is there, because it changes how hard you can push on price later: every dollar of supplier-owned fixture is a dollar of your volume they cannot afford to lose.

Amortised tooling sits in the middle and needs its own sentence: amortisation schedule and completion date in writing. "Tooling amortised" with no schedule means the $1.70/pc recovery never ends. Ask: over how many pieces, at what quantity step-downs, and does the price step down automatically when the schedule completes? Shops amortise cleanly every day — the ones who won't write down the schedule are the ones whose schedule you would not like.

A Decision Rule You Can Defend

Compress everything above into the rule we would apply as a buyer:

Lifetime quantity forecastWhat to acceptSentence to put in the PO
Under ~200 pieces, single runRefuse dedicated tooling; accept standard workholding and its price. If the supplier insists the part cannot be made without one, ask what the second-source design change is."No dedicated tooling; standard vise workholding."
200–800 pieces, repeat programmePay the one-off, take ownership, and quote the transfer clause. Check the break-even division first — with the fixture cost and per-piece saving stated separately."Tooling $X billed once; tooling is buyer property, transferable on request, stored maintained and insured by supplier."
800+ pieces or multi-year programmeFixture plus palletisation, one-off or fast amortisation; ask for the multi-part layout proposal explicitly.As above, plus: "Unit price steps down to $Y/pc after tooling recovery of N pieces on [date]."
Uncertain volume, testing the waterAccept supplier-owned tooling knowingly. Get the part, prove the design, and re-quote the tooling when volume is real."Tooling supplier-owned; buyer has right of first refusal to purchase at net book value."

That last clause is the one almost nobody writes and everybody should: a right of first refusal on supplier-owned tooling costs nothing at signature and converts a hostage situation into a quotation when the relationship ends.

Frequently Asked Questions

What does "tooling amortised" mean on a CNC quote?

It means the supplier is recovering the fixture cost through the piece price instead of billing it up front. A $900 fixture amortised over the first 400 pieces adds $2.25 to each of those pieces and nothing to pieces 401 onward. Always ask for the schedule — the number of pieces over which recovery happens and the price after recovery — because without it, amortisation quietly becomes a permanent surcharge.

How much does a CNC machining fixture cost?

For a typical 3-axis milled part: $400–1,200 for a dedicated machined fixture, $40–120 for soft jaws (which are closer to a consumable), $1,500–5,000 for hydraulic or pneumatic work, $600–2,000 for vacuum fixtures on thin-wall parts, and $800–3,000 for a multi-part pallet. Quotes far below these ranges for genuinely dedicated workholding usually mean standard workholding with a different name on the line.

When is a fixture worth it?

When lifetime quantity exceeds the break-even: fixture cost divided by per-piece saving. A $850 fixture saving $2.40 per part breaks even at 355 pieces. Below roughly 200 lifetime pieces, dedicated tooling rarely pays; above 800 it almost always does. The saving comes from shorter load time, eliminated second setups, multi-part cycles and lower scrap — ask for each of them quantified, not asserted.

Should I pay the tooling charge or let the supplier amortise it?

If you are confident in the volume, pay it: the one-off is capped and you stop paying at break-even, while amortisation overruns are the supplier's upside and your cost. If volume is uncertain, amortisation or supplier-owned tooling shifts the risk to the party better placed to carry it — just get the schedule, or the ownership, in writing.

Who owns the fixture after I pay for it?

Whatever the PO says — and if the PO says nothing, the answer defaults to the supplier, because the fixture sits in their shop under their asset tag. One sentence fixes it: "Tooling is buyer property, transferable on request, stored and maintained by supplier at no charge." Ask for it on the first order, not the day you need a second source.
